~/manufacturing operations

AI Automation for Manufacturing Operations: Connect Work Without Risking Control

An operations playbook for connecting maintenance, quality, inventory, and supplier work while keeping safety, machine control, production changes, and shutdown authority outside unproven automation.

Netholics MediaJuly 16, 202615 min read
~/60-second-answer

The 60-second answer

  • Start read-only: collect approved events, create work items, assemble evidence, and route exceptions before writing to production or control systems.
  • Separate IT workflow automation from operational technology; document every trust boundary, credential, network route, and permitted action.
  • Keep safety decisions, set-point changes, machine commands, quality disposition, release, and shutdown authority with approved systems and qualified people.
  • Measure response time, data completeness, false alerts, maintenance confirmation, queue age, and unauthorized-action attempts—not speculative productivity gains.
~/scope-boundary

Begin with the decision boundary

Manufacturing work spans ERP, MES, CMMS, quality systems, spreadsheets, email, supplier portals, sensors, and operational technology. The operational value often sits in the handoff: a condition becomes an inspected work order, a shortage becomes an owned supplier action, or a quality exception gains the right evidence.

Connecting these systems without boundaries can turn a convenience workflow into a production or safety risk. A generated diagnosis may be wrong, timestamps may not align, a stale asset identifier may route work incorrectly, or an integration credential may reach more systems than intended.

The first architecture should make recommendations and create reviewable work, not issue machine commands. Read-only evidence, least privilege, allowlisted destinations, idempotency, change control, and tested fallback paths matter more than a sophisticated model.

Scope boundaryThis guide covers business and maintenance workflow coordination. It is not industrial safety, controls-engineering, cybersecurity, quality-system, or regulatory advice and does not authorize direct autonomous control of equipment or processes.
~/operating-model

A five-stage human-owned workflow

The same control pattern can support several operational queues without pretending that every decision is automatable. Each stage creates an inspectable record and can stop safely.

  1. Capture the request. Collect the minimum approved source fields and preserve who or what supplied them.
  2. Validate context. Confirm identity, record, scope, destination, required fields, and applicable policy state.
  3. Create reviewable work. Classify and transform into a draft task, packet, response, or exception without making the protected decision.
  4. Apply the human gate. Send consequential, sensitive, ambiguous, or low-confidence work to the named authorized owner.
  5. Record and improve. Preserve source, transformation version, reviewer, outcome, correction, and follow-up evidence.
~/workflow-portfolio

Five workflows worth evaluating first

These are candidate operating patterns, not universal approvals. Start where the input is governed, the output is reviewable, and a named owner already manages the exception.

WorkflowBounded inputAutomation roleHuman gateOperating measure
Maintenance intakeApproved sensor/event summary and operator reportNormalize asset, event and work-order fieldsMaintenance planner verifies priority and job planTime to accepted work order
Inventory exceptionERP/MRP shortage or variance signalCreate exception record and supplier/buyer taskPlanner confirms demand, substitutions and actionAged shortages with named owner
Quality evidence packInspection record, lot, machine and approved attachmentsAssemble traceable nonconformance packetQuality authority determines dispositionPackets complete before disposition review
Shift handoffApproved production, downtime and open-work recordsGenerate source-linked shift summaryOutgoing and incoming leads approve exceptionsHandoff corrections and unresolved actions
Supplier follow-upPurchase order milestone and approved contact dataTrack promised dates and draft status requestBuyer approves message and commercial actionLate milestones resolved with evidence

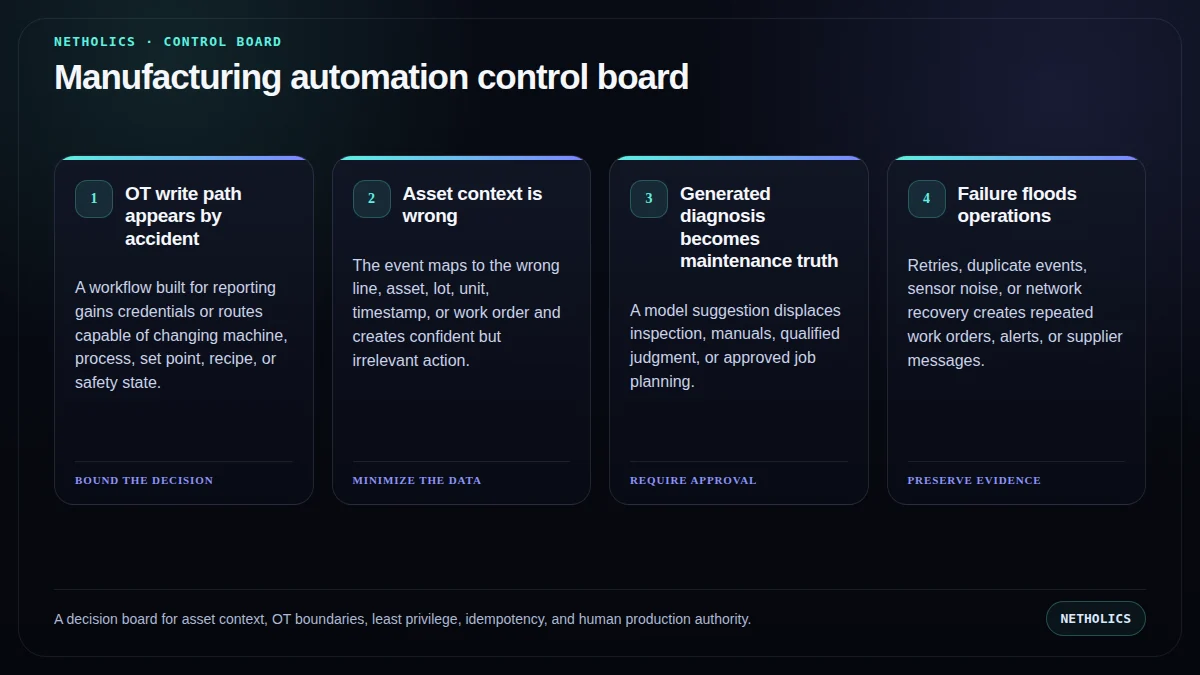

~/failure-modes

Four failures to design out

The primary risk is rarely a malformed prompt. It is an operating system that hides provenance, expands authority, or makes an exception look routine.

OT write path appears by accident failure

A workflow built for reporting gains credentials or routes capable of changing machine, process, set point, recipe, or safety state.

Asset context is wrong failure

The event maps to the wrong line, asset, lot, unit, timestamp, or work order and creates confident but irrelevant action.

Generated diagnosis becomes maintenance truth failure

A model suggestion displaces inspection, manuals, qualified judgment, or approved job planning.

Failure floods operations failure

Retries, duplicate events, sensor noise, or network recovery creates repeated work orders, alerts, or supplier messages.

~/operating-metrics

Measure service quality, not the AI story

Lock definitions before the pilot. Segment clean-path work from exceptions and preserve the denominator, time window, owner, and correction history.

MetricDefinitionReview use
Accepted work-item latencyTime from qualified event to an accepted task with correct asset, owner, evidence, and priority.Open a diagnostic queue; do not convert the signal into an unsupported outcome claim.
False and duplicate action rateAlerts or tasks rejected as noise, duplicate, stale, misrouted, or unsupported.Open a diagnostic queue; do not convert the signal into an unsupported outcome claim.
Evidence completenessWork, quality, or supplier records containing the required source, asset, lot, timestamp, owner, and approval fields.Open a diagnostic queue; do not convert the signal into an unsupported outcome claim.
Control-boundary violationsAttempts to use unapproved credentials, destinations, commands, write paths, or autonomous production actions.Open a diagnostic queue; do not convert the signal into an unsupported outcome claim.
~/control-record

A minimal control record

Keep source facts, automation output, human decisions, and final system state separate. The record should be understandable after the model, vendor, staff member, or interface changes.

workflow: manufacturing-maintenance-intake
mode: read-only-to-draft-work-item
trust_boundaries: [event-source, integration-zone, cmms]
prohibited_actions: [machine_command, setpoint_change, safety_bypass, auto_close]
controls: [allowlist, least_privilege, idempotency_key, rate_limit, dead_letter_queue]
human_gate:
  owner: maintenance-planner
  required_before: [priority, job_plan, dispatch, closure]
audit: [source_event, asset_map, transform_version, reviewer, final_work_order]

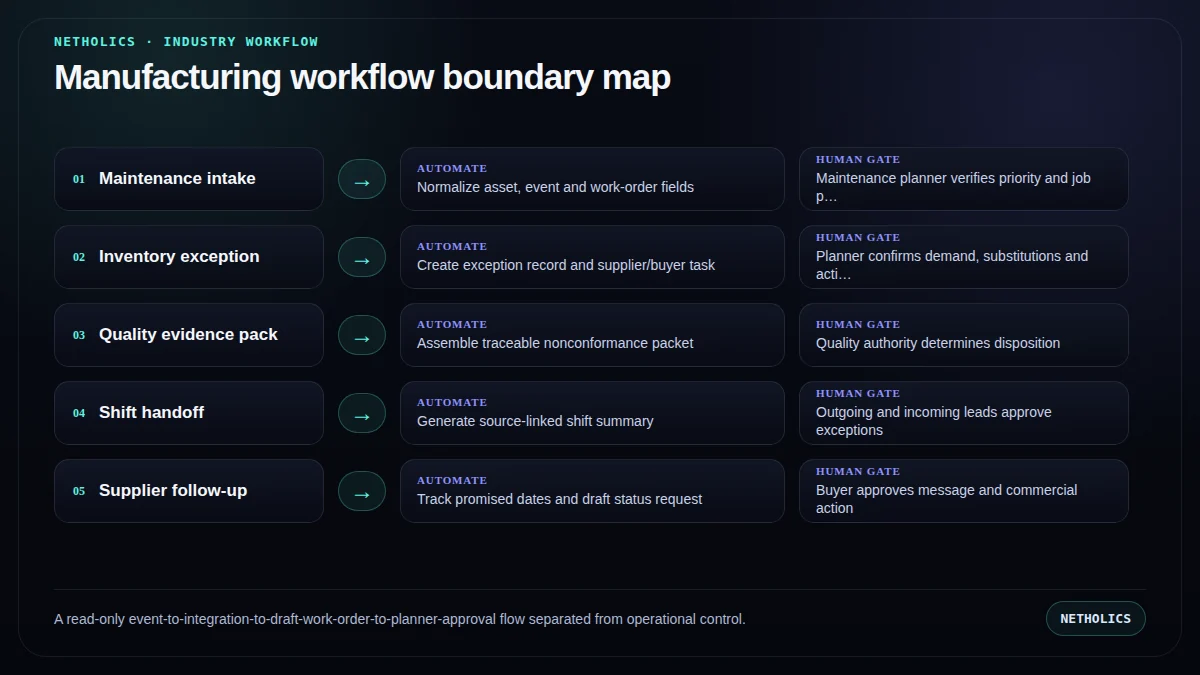

A read-only event-to-integration-to-draft-work-order-to-planner-approval flow separated from operational control.
A read-only event-to-integration-to-draft-work-order-to-planner-approval flow separated from operational control.
~/implementation-runbook

A practical implementation runbook

  1. Name the protected decision. Write what the system must never decide, send, change, approve, or suppress autonomously.
  2. Map data and authority. Inventory source systems, sensitive fields, identities, credentials, vendors, destinations, retention, and write permissions.
  3. Choose one bounded queue. Start with one read-only maintenance event feed that creates a draft CMMS work request for planner approval and cannot write machine commands, alter priority, or close work.
  4. Build exception-first. Define identity mismatch, missing data, conflict, low confidence, sensitive content, urgency, and policy exception routes before the clean path.
  5. Run in shadow mode. Compare proposed classifications and drafts with the existing process; record corrections without letting the workflow act.
  6. Approve a narrow production scope. Allow only the tested inputs, destinations, actions, owners, hours, volumes, and rollback conditions.
  7. Review evidence monthly. Inspect corrections, complaints, access failures, exceptions, policy changes, and whether the workflow still solves the original queue problem.
~/30-60-90

A staged 30–60–90 rollout

Days 1–30: map and baseline. Document the current queue, protected decisions, source systems, data classes, owners, failure paths, service times, and correction history. Test access and deletion before connecting production records.

Days 31–60: shadow the workflow. Let the system create proposed classifications, packets, tasks, or drafts while people continue the existing process. Compare every disagreement and repair policy, data, or routing before tuning prompts.

Days 61–90: release one bounded action. The recommended pilot is one read-only maintenance event feed that creates a draft CMMS work request for planner approval and cannot write machine commands, alter priority, or close work. Keep sending, record changes, consequential decisions, and material exceptions behind approval.

After day 90: expand by evidence. Add one queue, role, destination, or action at a time. Reassess vendor access, model behavior, policy, data, and rollback whenever the authority boundary changes.

~/what-experts-say

What primary sources actually support

NIST SP 800-82 Rev. 3: Guide to Operational Technology SecurityNIST SP 800-82 treats operational technology as a distinct security domain with safety, reliability, and operational consequences. That supports explicit IT/OT boundaries and defensive architecture; it does not validate direct AI control of plant equipment.

Read the official source

Netholics boundary: official material defines regulatory, privacy, security, or governance context. It does not certify this article, approve a vendor, or replace qualified sector-specific review.

~/implementation-checklist

Implementation checklist

  • A named business owner and qualified policy reviewer approve the scope.
  • The protected decisions and prohibited autonomous actions are explicit.
  • Source, inferred, reviewed, and final values remain distinguishable.
  • Sensitive fields, identities, roles, credentials, retention, and vendor access are mapped.
  • Every consequential or low-confidence path has a tested human escalation.
  • Draft, approval, send, system-change, and exception states are visibly different.
  • Logs contain enough evidence to investigate without copying unnecessary sensitive data.
  • The pilot has a baseline, rollback trigger, correction metric, and review date.
A decision board for asset context, OT boundaries, least privilege, idempotency, and human production authority.
A decision board for asset context, OT boundaries, least privilege, idempotency, and human production authority.
~/decision-card

Automation readiness card

DecisionAssessment
ImpactHigh when a repetitive queue delays customers, staff, records, or downstream work and already has a responsible owner.
RiskHigh when the workflow touches sensitive data, protected decisions, vulnerable people, safety, money, rights, or external communications.
EffortMedium to high; integration is often easier than data classification, authority design, exception handling, supervision, and evidence retention.
Best first workflowOne read-only maintenance event feed that creates a draft cmms work request for planner approval and cannot write machine commands, alter priority, or close work.
Do not automate yetWhen policy ownership, source-of-truth records, identity, escalation, access, or rollback cannot be demonstrated.
~/faq

Frequently asked questions

Q: What manufacturing workflow should be automated first?

Choose a read-only event-to-draft-work-item flow with clear asset identifiers, a human planner, measurable queue delay, and no machine-control permissions.

Q: Should AI send commands to production equipment?

This playbook does not recommend autonomous machine commands, set-point changes, safety bypasses, or production-control changes.

Q: How should IT and OT be separated?

Document network, identity, credential, data, and action boundaries. Use least privilege, allowlisted routes, monitored integration zones, and qualified security and controls review.

Q: Can AI diagnose equipment failures?

It may help organize evidence or propose hypotheses, but qualified maintenance processes should verify asset context, inspection evidence, manuals, and the approved job plan.

Q: Which reliability controls matter?

Use idempotency, rate limits, retry limits, dead-letter queues, source timestamps, asset mapping, duplicate detection, and a tested manual fallback.

Q: What should the pilot measure?

Measure accepted work-item latency, false or duplicate tasks, evidence completeness, planner corrections, and any attempted control-boundary violation.
